One of the most common questions we get from homeowners in Denton, TX, and across Dallas-Fort Worth before starting a patio project: “How long is this actually going to take?” It’s a fair question and one that deserves a straight answer, not a vague “it depends.”
The honest answer is that patio installation timelines in North Texas vary depending on material, size, permit requirements, and site conditions but they’re also predictable when you understand the phases involved. This guide breaks down real timelines for DFW homeowners by patio type, explains every phase from first site visit to final inspection, and tells you exactly what can extend a timeline so you can plan accordingly.
This is a cluster article from our ultimate guide to luxury outdoor living in North Texas. For material comparisons and pricing, visit our luxury patio construction service page.
Patio Installation Timelines in DFW: The Quick Answer
For most homeowners in Dallas-Fort Worth, a standard patio project takes 1-4 weeks from start to finish, including site preparation, installation, and any required inspections. Larger, more complex projects with permits, multiple materials, or integrated features like pergolas and outdoor kitchens take longer. Here’s a complete breakdown by project type:
| Patio Type | Construction Days | Total w/ Permits | Main Timeline Driver |
|---|---|---|---|
| Basic Concrete Slab | 3-5 days | 1-3 weeks | Concrete cure time (7-10 days minimum) |
| Stamped Concrete | 4-6 days | 1-3 weeks | Stamping + sealing cure window |
| Concrete Pavers (simple layout) | 5-8 days | 1-2 weeks | Base compaction & joint sand setting |
| Concrete Pavers (complex pattern) | 8-14 days | 2-3 weeks | Custom cuts, pattern alignment |
| Travertine Pavers | 6-10 days | 2-3 weeks | Material lead time + precision setting |
| Natural Limestone / Flagstone | 8-14 days | 2-4 weeks | Hand-fitting irregular pieces |
| Large-Format Porcelain | 7-12 days | 2-3 weeks | Perfectly flat base requirement |
| Patio + Pergola Combined | 2-4 weeks | 4-6 weeks | Structural permit + sequential phases |
| Patio + Outdoor Kitchen | 3-6 weeks | 6-10 weeks | Trade permits (gas, electric, plumbing) |
* Construction days = active build time, weather permitting. The total timeline includes permit approval, material lead times, and scheduling. Orange rows = multi-phase projects requiring sequential trade coordination.

Every Phase of a Patio Installation and How Long Each Takes

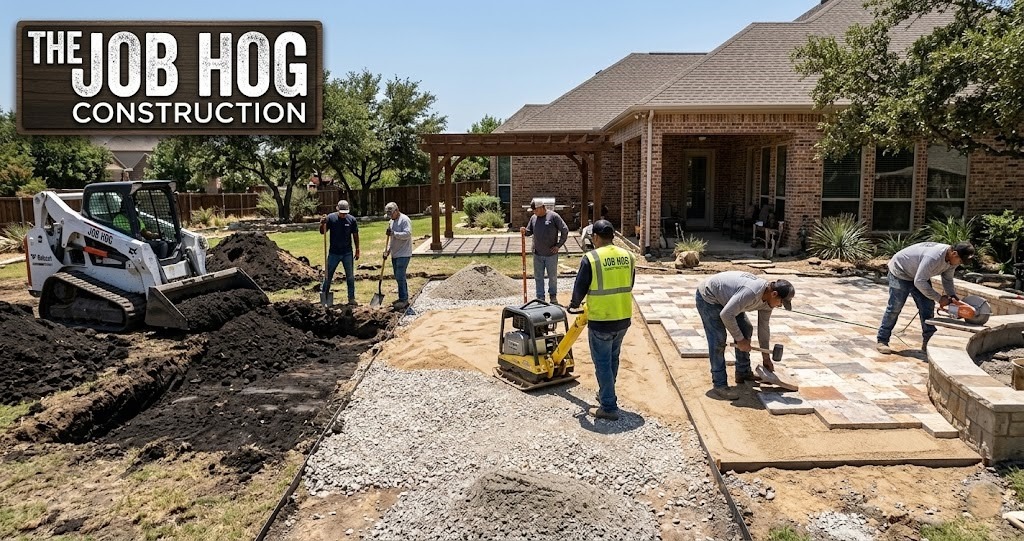

The total project duration isn’t just active construction time; it includes pre-construction planning, permit processing, material procurement, and post construction inspection. Here’s what every phase looks like near Fort Worth, Dallas, and Denton:
| Phase | Typical Duration | What Happens |
|---|---|---|
| 1. Site Assessment & Design | 1-3 days | Site visit, measurements, soil assessment, drainage planning, design finalisation |
| 2. Permit Application | 3-15 business days | Submitted to city building dept. Dallas/Fort Worth/Denton vary – we handle all of this |
| 3. Material Procurement | 3-10 days | Pavers, stone, aggregate base, drainage materials ordered and delivered to site |
| 4. Site Preparation & Excavation | 1-2 days | Existing vegetation removed, area excavated to required depth (4-6″ minimum in DFW clay) |
| 5. Base Installation | 1-2 days | Crushed aggregate laid and mechanically compacted in lifts – critical for DFW clay soil |
| 6. Drainage Installation | 0.5-1 day | Channel drains, French drains, or grade corrections installed before surface goes down |
| 7. Surface Installation | 2-10 days | Pavers/stone laid, cut, aligned, and compacted. Complexity and pattern drive duration |
| 8. Finishing & Clean-Up | 0.5-1 day | Joint sand swept and compacted, edges secured, site cleaned, final inspection scheduled |
| 9. Final Inspection | 1-3 days | Channel drains, French drains, or grade corrections are installed before the surface goes down |
* Phase 2 (permits) runs concurrently with material procurement in most cases – experienced contractors overlap these phases to minimise total project duration.
What Can Extend Your Patio Timeline in North Texas?
Most timeline overruns on patio projects in DFW come from a handful of predictable causes. Understanding them helps you plan accurately and ask the right questions before signing a contract:
1. Permit Processing Times
Permit approval timelines vary significantly across DFW municipalities. Dallas and Fort Worth city building departments typically process residential patio permits in 5-10 business days. Denton runs 3-7 business days for straightforward projects. Frisco and Plano are generally faster at 3-5 days. Projects with structural elements, drainage modifications, or utility work take longer. The Job Hog submits all permit applications on the day the contract is signed to minimise waiting time.
2. DFW Weather Specifically Spring Storm Season
North Texas’s spring storm season (March through May) is the single most common cause of construction delays on outdoor projects. Heavy rain prevents excavation, makes base compaction impossible, and can wash out freshly installed aggregate before pavers go down. Experienced DFW contractors build weather buffer days into every spring project schedule. If your project runs from March through May, expect a 10-20% schedule buffer for weather.
3. Material Lead Times
Premium materials, particularly natural travertine, imported limestone, and large-format porcelain, are not always in local DFW stock. Lead times of 5-14 days are common for specialty stones. The Job Hog confirms material availability and orders before the start date is set, so supply delays don’t push your project out unexpectedly.
4. Site Conditions Discovered After Excavation
North Texas’s clay soil occasionally reveals surprises after excavation begins, buried tree roots, old concrete from a prior structure, or, significantly deeper, poor soil than the surface indicated. These conditions require additional base work and can add 1-3 days to the schedule. A professional contractor will communicate these discoveries immediately and provide a revised timeline before proceeding.

Best Time of Year to Install a Patio in DFW
📅 Optimal Patio Installation Windows in North Texas
BEST: October November & February March mild temperatures, dry conditions, minimal weather delays, contractor availability better than summer peak.
GOOD: September & April weather is transitional but manageable with schedule buffers.
CHALLENGING: May August summer heat slows crews and affects some material curing; spring storm season (May) adds weather risk. Still buildable, but plan extra buffer days.
AVOID STARTING: Late December, January if heavy frost is forecast, ground freezing affects base compaction and concrete work.
The most popular time for DFW homeowners to start patio projects is spring; everyone wants their space ready for summer. The practical reality is that fall installation gives you a better experience: mild weather means faster construction with fewer delays, and the finished patio is ready for immediate use through the pleasant North Texas fall season, then fully settled and cured before the following summer’s heavy use.
What to Ask Your Contractor About the Timeline Before Signing
A professional patio contractor in DFW should be able to give you specific, written answers to these questions before you sign anything:
- What is the specific start date, and what are the milestone dates for each phase?
- How many weather buffer days are built into the schedule?
- When will you submit the permit application, and how long does your city typically take?
- Are all materials in stock, or do any require a lead time that could shift the start date?
- What happens if unexpected site conditions are found during excavation?
At The Job Hog, every homeowner receives a written project schedule with phase milestones before we begin. No vague “a few weeks” answers a real schedule you can plan around.
✅ The Job Hog’s Timeline Promise to DFW Homeowners
We provide a written project schedule before work begins. We submit permit applications on contract signing day. We order all materials upfront to eliminate supply delays. We communicate any site discovery immediately, the same day. And we back every schedule with a named project contact you can reach directly. Our goal: no surprises, no excuses.
